How long does it take to build a new house in Australia?

When someone says a house takes “about a year”, they mean from approval. From the first time you look seriously at a block, the timeframe is often longer.

Written and verified by Struqt’s registered architects · Last verified October 2026

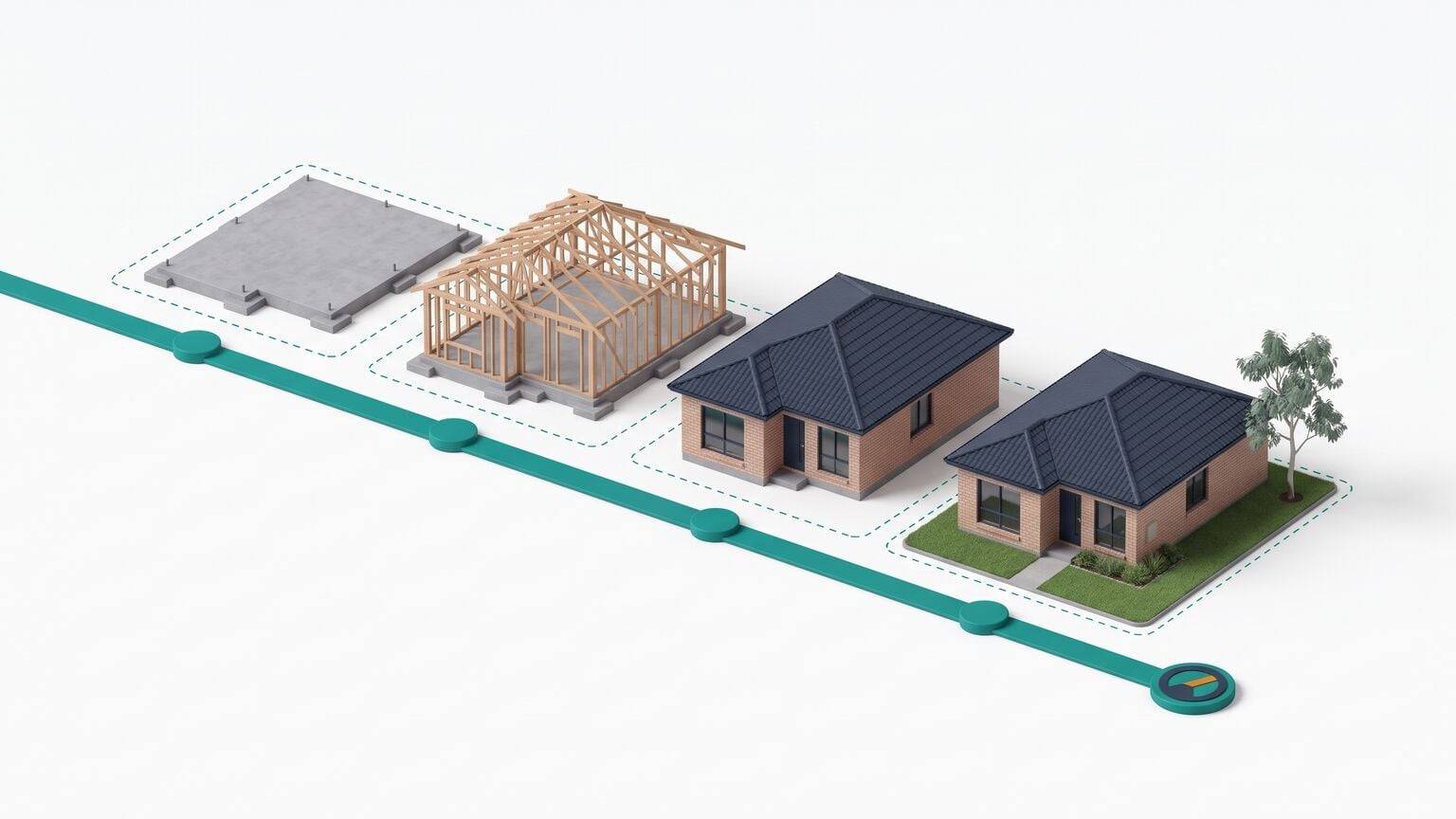

Isometric illustration of the same single-storey brick house on four suburban blocks, at slab, frame, lock-up and finished stages, joined by a teal timeline with a checkpoint at each stage.

A new detached house in Australia took about 10.7 months on average from building approval to completion in 2025-26, with about 8.4 months of that spent building on site. Site acquisition, design and planning approval come beforehand, adding months to the overall process.

Source: ABS Building Activity, Australia, June 2026

The number everyone quotes is half the picture

The official build-time figures come from the Australian Bureau of Statistics. The ABS measures how long new houses take from building approval, the permit that lets work start, through to the date the home is finished.

Although this can be a helpful indicator of how long a house takes to get built, it doesn't account for the time taken to purchase the land, have it surveyed, design a house and have it approved. The ABS publishes the time in two parts:

  • Approval to start on site: about 2.3 months nationally in 2025-26, but almost 4 months in South Australia. This is usually finance, contracts, the builder's schedule and site set-up.
  • Start on site to finish: about 9.2 months in 2024-25, falling to roughly 8.4 months in 2025-26, the quickest since 2021-22.

This timeframe also varies greatly depending on the type of build you undertake. A volume builder building a pre-designed home can take months off the process compared with an architectural or custom-designed home on a tricky site.

Every stage, from first site check to keys

A new house moves through three phases: getting ready, getting approved, and building. Here's what happens at each stage and roughly how long it takes.

  1. Stage 1

    Feasibility and site checks

    Confirm what the zone allows, which overlays apply (heritage, bushfire, flood), what's on the title (easements, covenants) and whether water, sewer and power are available.

    Roughly how long: Minutes for the zone and overlays with a Struqt report. Days to weeks for the title and services, or for a planner or your builder to check the lot.

  2. Stage 2

    Survey and site investigations

    Feature and level survey, soil test to classify the site for footings, plus a bushfire or flood assessment if an overlay applies.

    Roughly how long: 1 to 2 months

  3. Stage 3

    Design and documentation

    First sketches, then the developed design, then working drawings, engineering and the energy rating your builder and certifier need.

    Roughly how long: 2 to 6 months, sometimes more

  4. Stage 4

    Planning approval

    Council or the state assessor checks the design against the planning rules for your zone. Some houses skip this or get a fast-track check.

    Roughly how long: 5 business days to 3 months or more (see the state table below)

  5. Stage 5

    Building approval

    A building surveyor or certifier checks the drawings against the National Construction Code. Depending on the state, they or the council then issue the building permit.

    Roughly how long: Varies by state, from about 2 weeks to a month or more once the paperwork is complete

  6. Stage 6

    Finance, contract and start date

    Construction loan, signed building contract, and waiting for the builder to schedule your job.

    Roughly how long: About 2.3 months on average from building approval to the first work on site (ABS, 2025-26). Finance and the contract can run alongside building approval.

  7. Stage 7

    Site works and base

    Site cut, footings and slab (or footings and base brickwork for a timber floor).

    Roughly how long: 3 to 6 weeks

  8. Stage 8

    Frame

    Wall and roof frames go up. In some states, including Victoria and Queensland, the frame must be inspected before it's covered.

    Roughly how long: 2 to 4 weeks

  9. Stage 9

    Lock-up

    Roof on, external walls clad, windows and external doors fitted. The house can be locked.

    Roughly how long: 4 to 8 weeks

  10. Stage 10

    Fixing

    Plasterboard, cabinetry, internal doors, skirting, architraves, wet areas fitted out.

    Roughly how long: 4 to 8 weeks

  11. Stage 11

    Practical completion and handover

    Painting, final fit-off, cleaning, your pre-handover inspection, final certificates, keys.

    Roughly how long: 4 to 8 weeks

Stage durations are based on a single-storey brick veneer home. Stages 7 to 11 together took about 9.2 months on average in 2024-25 and about 8.4 months in 2025-26 (ABS). That average is longer than the ranges above add up to because it covers every kind of new house, including double-storey and custom homes, and any delays between stages.

Stages 7 to 10 are the stages Victorian law uses for progress payments, and many contracts elsewhere use similar ones. For a full contract, Consumer Affairs Victoria gives the usual schedule as 10% at base, 15% at frame, 35% at lock-up and 25% at fixing, and the law caps what a builder can claim at each stage at those amounts. Knowing when each one lands matters, because that's when your bank draws down the loan.

What the build itself costs is a separate question, covered in how much it costs to build a house.

How long it takes in each state and territory

In 2025-26, a new house took about 10.7 months on average from building approval to completion. South Australia was the slowest in the country at 12.9 months. The Northern Territory was fastest at 8.2 months.

Northern Territory

8.2 months in 2025-26 · 8.7 months in 2024-25

Approval to start 1.4 months · start to finish 6.8 months

Victoria

9.2 months in 2025-26 · 9.8 months in 2024-25

Approval to start 1.7 months · start to finish 7.5 months

Queensland

9.6 months in 2025-26 · 9.2 months in 2024-25

Approval to start 2.1 months · start to finish 7.6 months

Australia

10.7 months in 2025-26 · 11.5 months in 2024-25

Approval to start 2.3 months · start to finish 8.4 months

New South Wales

11.6 months in 2025-26 · 12.2 months in 2024-25

Approval to start 2.6 months · start to finish 9.0 months

Tasmania

11.7 months in 2025-26 · 11.8 months in 2024-25

Approval to start 2.8 months · start to finish 8.9 months

ACT

12.1 months in 2025-26 · 13.0 months in 2024-25

Approval to start 2.1 months · start to finish 10.0 months

Western Australia

12.5 months in 2025-26 · 15.5 months in 2024-25

Approval to start 2.3 months · start to finish 10.2 months

South Australia

12.9 months in 2025-26 · 13.7 months in 2024-25

Approval to start 3.9 months · start to finish 9.0 months

Source: ABS Building Activity, Australia, June 2026 (released 7 October 2026), average commencement and completion times for new houses. The ABS publishes these in quarters; we've converted them to months. Each total adds the two published averages, so the rounded figures may not add exactly.

Every state except Queensland got faster than the year before. Western Australia improved the most, cutting three months. South Australia's slow spot is the wait between approval and starting on site: 3.9 months, more than double Victoria's. South Australia has had the longest wait in the country at that step in every year of the ABS series, back to 2015-16.

Delayed construction start times can be a result of many contributing factors. Common culprits are the builder's queue of jobs, low trade availability or slow finance approvals.

How long planning approval takes in each state

Most states and territories set a deadline for council or the state assessor to decide a planning application. Real-world times are often longer due to councils requesting further information, which usually stops or restarts the assessment clock.

South Australia

5 business days for a 'deemed-to-satisfy' house (one that ticks every standard box); 20 business days if it's assessed on merit

Advertised or referred: 50 business days with most referrals (40 for some agencies); 50 with public notice, or 70 if a panel decides

Asked for more information: Clock stops

Victoria

10 business days under VicSmart; 60 days for a standard permit, after which you can ask VCAT to decide

Advertised or referred: Referral authorities get 28 days to respond

Asked for more information: If council asks within 28 days (5 business days for VicSmart), the count starts again from the day you answer

New South Wales

Treated as refused after 40 days if undecided. In practice councils averaged 84 days at May 2026, and are targeted at 90 days in 2026-27, falling to 65 days by July 2028

Advertised or referred: 60 days if another agency must agree to or approve it

Asked for more information: Clock stops, if council asks within 25 days of lodging

Queensland

Decision stage up to 35 business days

Advertised or referred: Public notice for impact-assessed applications runs at least 15 business days (30 with a variation request)

Asked for more information: Clock stops. Applicants generally get up to 3 months to respond

Western Australia

60 days

Advertised or referred: 90 days if it's advertised or referred to another agency

Asked for more information: Clock stops only if you agree to the council's request

Tasmania

28 days for a 'permitted' application

Advertised or referred: 42 days for a 'discretionary' one, including 14 days on public exhibition

Asked for more information: Clock stops, if the council asks within 21 days (14 for a permitted application)

ACT

30 working days (the count skips 20 December to 10 January)

Advertised or referred: 45 working days if comments are received; 60 for significant development

Asked for more information: Clock stops until you answer

Northern Territory

No deadline in the Planning Act. The NT Government says applications usually take about 8 weeks

Advertised or referred: You can ask for a review if there's no decision within 84 days

Asked for more information: No clock to stop. You get 30 days to answer a request

Many new houses can bypass a planning application. If the design meets every standard for the zone and no triggering overlays apply, several states let it go straight to building approval or through a fast-track process.

Which pathway a house takes, and what each state calls it, is set out in CDC vs DA, accepted development in Queensland and the R-Codes in Western Australia.

What blows out a timeline

The averages hide a wide spread. These are the things that push a build from the fast end to the slow end.

  • A request for more information. In most states the approval clock stops the day council asks for more detail and only restarts when you answer. In Victoria it starts again from the beginning. A slow reply can cost weeks. Missing information on the drawings is a common cause.
  • Overlays on your block. Heritage, bushfire, flood and similar overlays usually mean extra reports and a referral to another agency. In South Australia, a referral can take a merit application from 20 business days to 50.
  • Public notice. If neighbours have to be told, add the notice period plus time for any objections to be dealt with. A design that departs from the planning rules is a common trigger.
  • Finding things in the ground. Rock, filled land, a high water table or reactive clay can change the footing design after you've started.
  • Builder capacity. At the end of June 2026 there were 95,447 houses under construction across Australia, up 11.8% in a year. More jobs on the go means more competition for the same trades.
  • Market conditions. Covid put significant strain on the building industry, increasing demand and leading to trade and material shortages. Before 2021-22 a new house took about 6.5 to 6.7 months from start to finish; by 2023-24 it took 10.4 (ABS).
  • Changes after you sign. Every variation to the design or selections can mean re-ordering, re-pricing and sometimes re-approval.

Most of these are known before you buy, or before you start design. That's when they're cheapest to deal with.

The overlays that most often add a report and a referral are explained in heritage overlays and flood overlays.

Know your timeline before you commit

Key takeaway: The biggest swing in a build timeline isn't the builder. It's whether your block needs a full planning application, a referral or public notice, and that comes down to its zone and overlays.
